Planning systemPart 1 of 2Drawing 10.1 of 37
The plan
The plan has one number on the front sheet and the three year timeline under it. It's eighteen sheets, 287 formulas and a set of macros.
- StatusBuilt and used, 2019 to 2021, last version 10.0
- SizeTwo workbooks, 40 sheets, about 300 formulas, plus macros

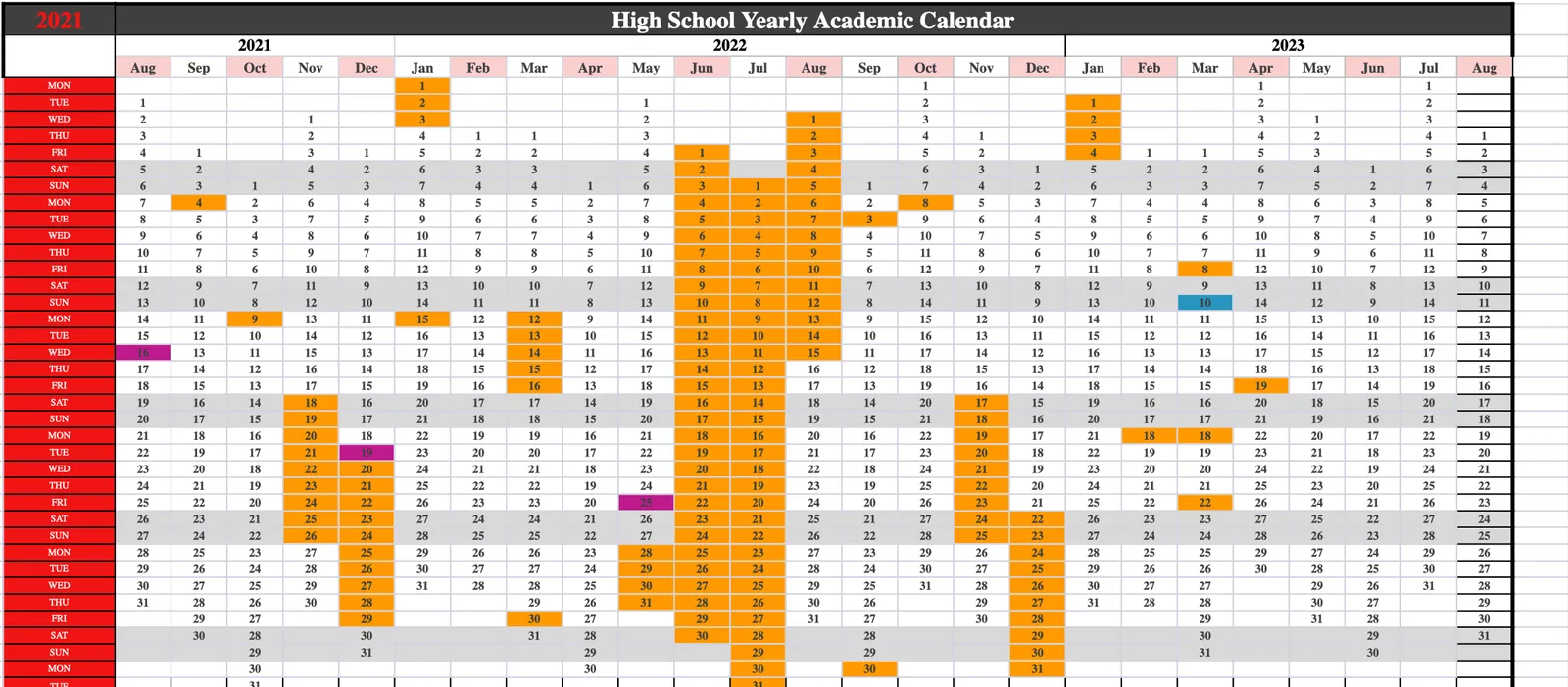

- SpanA plan running from eighth grade to twelfth, 2020 to 2025
- Built inExcel, no code beyond what the spreadsheet gives you
Sheet 02 of 03/Shape
How it's put together

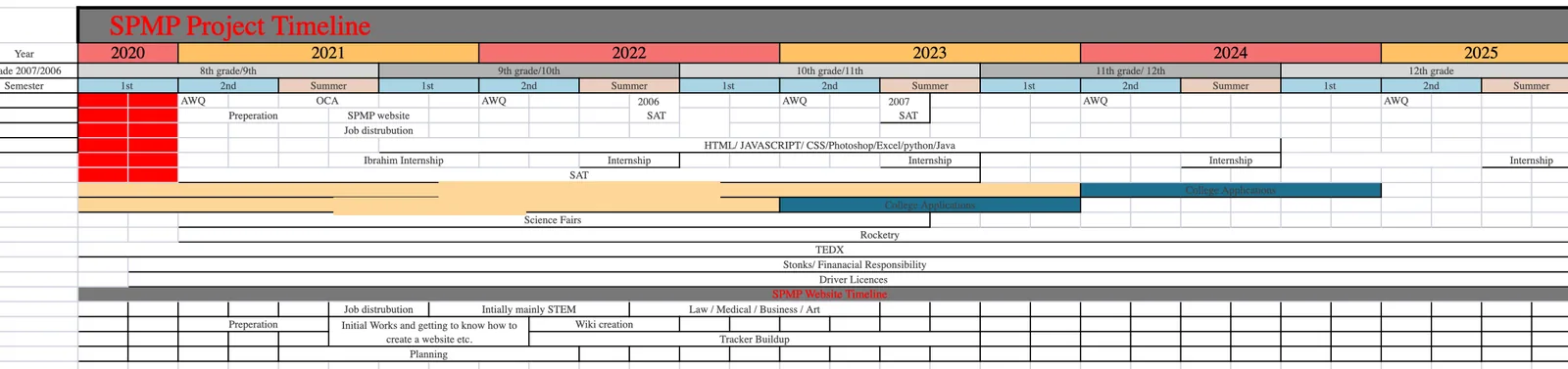

Every goal on the front page rolls up into one percentage. Each area breaks down into smaller pieces under it, like the SAT, which splits into math, math with a calculator, English and writing.

Sheet 03 of 03/Program
Written for more than one person
It's written in third person all the way through, with lines like "skills that parents and advisor want students to learn." The timeline also runs two birth-year groups, tagged 2006 and 2007, side by side on the same lanes.
